Monitor Expected Backup Uploads

Essentials+ Upload Monitoring is schedule verification in continuous form: it shows whether each expected backup arrived on time, arrived late, or never reached the SFTP account. Open the account and select Upload Monitoring after at least one representative upload has established the expected workflow.

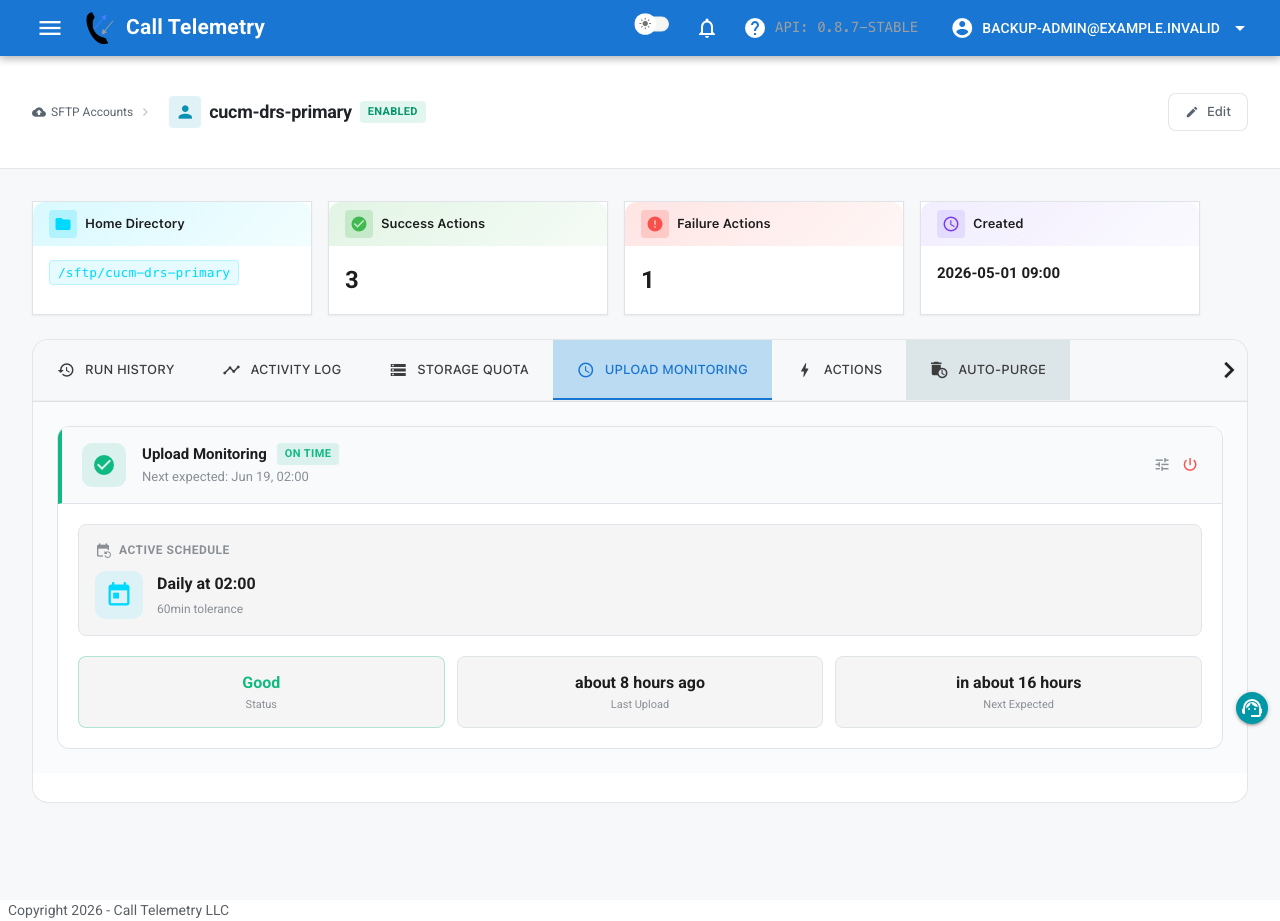

Screenshot of the Essentials+ Upload Monitoring tab showing an on-time daily CUCM backup schedule, next expected upload, and tolerance window

Essentials+ — expected-upload schedule, current status, and tolerance window.

Configure the Expected Schedule​

  1. Choose Hourly, Daily, Weekly, or Monthly.
  2. Set the expected upload time and, when applicable, the weekday or day of month.
  3. Set Tolerance Window to the grace period allowed after that time.
  4. Set Alert Threshold to the number of consecutive misses required before notification.
  5. On Essentials+, add Email Recipients, Webex rooms, or Webex direct recipients available to the organization. Community does not send email or proactive notifications.
  6. Enable monitoring and verify that the status header shows the next expected upload.

The summary card may show Good as its overall health metric while the schedule header shows On Time. Good means the current schedule is on track; On Time is the evaluated outcome for the latest expected upload.

tip

The tolerance window should cover normal DRS duration and transfer variation without hiding a meaningful delay. Start with observed backup timing, then adjust after reviewing several successful cycles.

Interpret Monitoring Status​

StatusMeaningOperator Response
On TimeThe upload arrived within its expected windowNo action required
LateThe upload arrived after the tolerance windowReview DRS and network duration
MissingThe configured miss threshold was reachedInvestigate the source and transfer path immediately
DisabledMonitoring was turned offRe-enable it when the expected schedule should be evaluated

Verify Alert Delivery​

After saving the schedule, confirm that the intended recipients and Webex destinations appear in the configuration.

warning

Use a controlled test window when validating missed-upload alerts; do not disable a production backup merely to force a notification.

When an alert fires, correlate the account's Upload Monitoring, Run History, and Activity Log before changing the schedule. A missing upload can originate in CUCM DRS, authentication, routing, storage, or the transfer itself.
